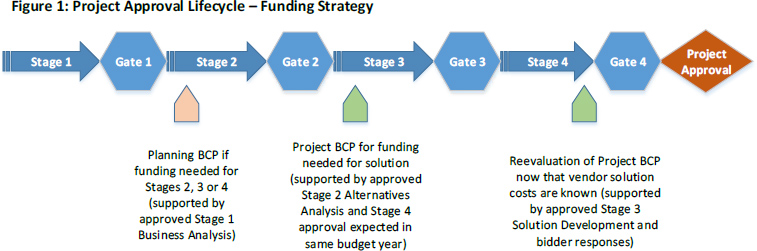

Can my project still be approved if the project cost estimates from the Stage 2 Alternatives Analysis change after receiving vendor responses in Stage 4 Project Readiness and Approval?
If the “Total Project Cost” in the Stage 4 Project Readiness and Approval significantly deviates from the “Total Project Cost” estimated in the Stage 2 Alternatives Analysis, the Agency/state entity may be required to take action in accordance with the following conditions.
Project Condition at Stage 4 | Agency/State Entity Action | Admin Action | Result |
---|---|---|---|
Total Project Cost estimated in Stage 2 is greater than or equal to Total Project Cost estimated after bids are evaluated in Stage 4 | No Action Necessary | Project approved based on final project cost | Award Contract |
Total Project Cost estimated in Stage 2 is within 20% or $5 million (whichever is less) of Total Project Cost estimated after bids are evaluated in Stage 4 | Revise PAL Stage/Gate Deliverables to reflect change in project cost (may include updated budget action for increased funding to specific budget years, redirected funds, etc.) | Project approved with condition that updated PAL document is approved | Award Contract |
Total Project Cost estimated in Stage 2 is within 20% or $5 million (whichever is less) of Total Project Cost estimated after bids are evaluated in Stage 4 |
|
Project is not approved, proposal is on hold pending additional analysis to determine viability of project | Proposal on Hold |
